CHILE

DATE: 2010-2014

MODEL: MC 3D

The Angostura Hydro Electric Power Plant is one of the major hydroelectric projects carried out in the country in the past decade.

Chile’s burgeoning economy and the growth of its mining sector have increased the demand for electricity in the country. Especially the South-central part of Chile can benefit of natural environment and climate conditions that allow for the inexpensive, sustainable hydroelectric generation of electricity. The Angostura Hydro Electric Power Plant is one of the major hydroelectric projects carried out in the country in the past decade. The construction of the Plant has involved a number of innovative technologies, especially in the execution of the foundation works.

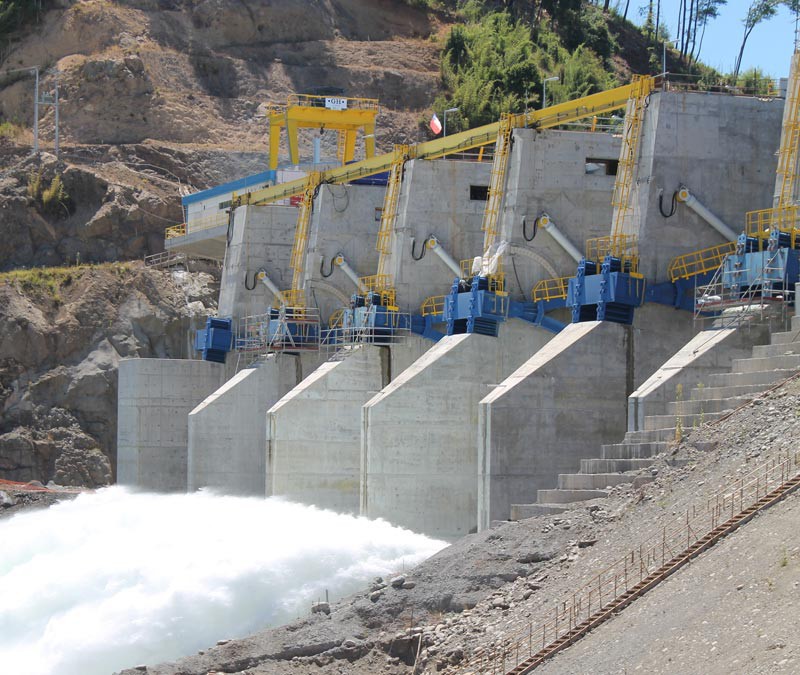

img1_immagine

Located approximately 600 km south of Santiago, in the municipality of Santa Barbara y Quilaco, in the Biobío Region, the Angostura Hydro Electric Power Plant is the largest hydroelectric plant built in Chile since 2004. Developed by the Chilean utility company Colbún and launched in April 2014, the power plant has a capacity of 316 MW and an average annual generation capacity of 1,542 GWh. The Angostura Hydro Electric Power Plant uses water resources of the Huequecura and Biobío rivers using a reservoir of minimal regulation, which allows a variation no higher than one meter in the water level, thus minimizing its environmental impact and enabling tourism development in their environment.

The plant covers an area of 641 acres and stores some 100 million m3 of water. The Plant features three vertical Francis turbines: two 136 MW Francis turbine-generator sets and one 46 MW ecological discharge Francis turbine, provided by Alstrom. Its architecture allows enough flexibility to operate both in times of higher flow, as is the case in winter, or with lower flow, as in the summer. It also has the largest turbine hall in the country - 59 meters high, 177 m long and 30 m wide.

Construction of an earth dam

The construction project was awarded to the Italian group Salini-Impregilo for a total amount of 240 million Euro. Construction began in February 2010. The main civil works included the construction of an earth dam approximately 1.6 km long and 25 meters high on the left bank of the river and the construction of a RCC (Roller-Compacted Concrete) dam 125 m long and 63 m high with a spillway incorporated along the Bío-Bío River.

Although the bedrock formed of sedimentary rock offered good conditions for placing a dam on it, the project requirements included waterproofing of the dam body by means drilling and grouting with cement. The drilling operations were also aimed to identifying and securing any weak or permeable zones along the dam structure.

The Chilean foundation contractor Pilotes Terratest S.A. was in charge of the execution of all the drilling works, including injections and waterproofing, consolidation, drainages and instrumentation installation (piezometers and inverted pendulum).

“Some of the works were performed opencast”, says Alberto Mukden, Production Manager at Pilotes Terratest, “but the majority of them was carried out underground, and involved the diversion tunnel, outlet tunnel, the dam, the drainage gallery, headrace tunnels, discharge tunnels, turbine hall and access galleries to the turbine hall.”

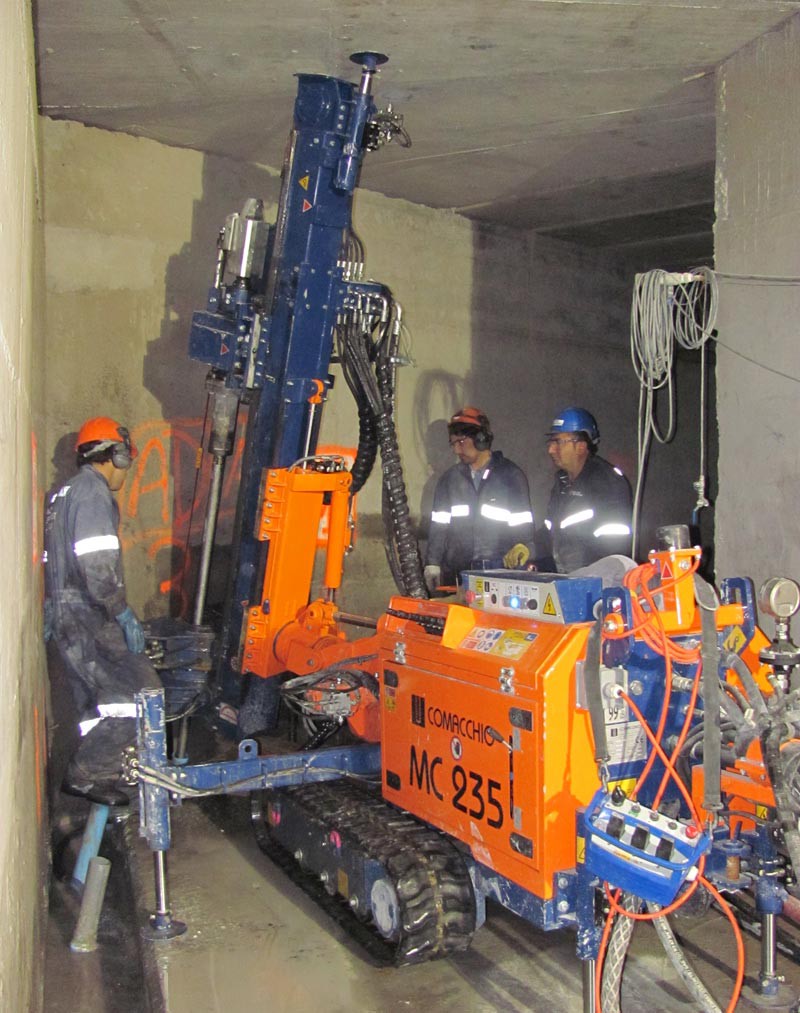

img2_immagine
img3_immagine

The main challenge was that the majority of waterproofing drilling operations had to be carried out inside very low roofed tunnels and galleries of 2.4 m wide x 2.5 m height.

In order to meet this requirement, Pilotest Terratest chose a Comacchio drill rig MC 3 D with a separate power pack. Due to its compact size (the unit is only 1.15 m wide and features a 2.3 m long mast), the rig could be successfully operated inside the small galleries incorporated into the dam structure.

“The drill rig features a variable width undercarriage that is 750-1,150 mm wide, thus allowing for operation even in very confined spaces” – explains Comacchio’s Sales Manager Flavio Durigan – “The mast has 1,200 mm feed stroke, offering 2500 daN feed / retract force, this allows for operation in low overhead conditions. Also, the machine is equipped with electric power pack delivering 55 kW, avoiding emissions and reducing noise level, thus providing a safe work environment for all workers. The power pack is also mounted on an undercarriage with adjustable width from 1 to 1.5 m, fitting the limited space inside the galleries. The rubber track undercarriages of both drill rig and power pack ensured that no damage was caused to the concrete floor of the galleries”.

Water-proofing of the bedrock was done by drilling 64 mm holes and then grouting with cement for a total of 7,018 drilling meters. Part of the drilling took place in cramped galleries, with very limited free space to operate on above the drill rig. Drill tubes as short as 1 meter had to be used, making straight drilling particularly difficult.

“The drilling needed for waterproofing of the bedrock was performed using an innovative technique” - explains Alberto Mukden - “We implemented for the first time a rotary-percussive drilling system with hydraulically driven DTH hammer developed by Wassara. The advantage of this system is that no compressed air is required, thus there is no harmful noise in the working place, the hydraulic power pumped to the hammer has practically no loss and there is a better control over borehole deviation.”

The allowed borehole deviation was set to 2% at full length (up to 60 m). We are proud to say that this requirement was met by far, despite the extreme low headroom and the 1.2 m free stroke length. Also, the use of water-powered drilling offered a considerable reduction of the noise level, resulting in a healthy, dust-free and comfortable drilling environment for all the people working inside the galleries”.

“The other major advantage of this system is the great productivity: we managed to improve the production ratios up to 20% as compared to the traditional systems using compressed air”.

The Wassara system was also used for the drainages with 102 mm drilling along the dam body and along the galleries that surround the turbine hall.

The drilling operations were very extensive and included among the rest

• 4,665 m if rotary-percussive drainage drilling, 100 mm drilling diameter

• 1,429 m with 15 m length “upwards” and 2,336 m with 45 m average length “downwards” drilling

• 1,484 m rotary-percussive drilling for consolidation works with 64 mm drilling diameter

• 7,018 m rotary-percussive drilling for waterproofing with 64 mm drilling diameter

• 853 m of diamond drilling with HQ3 system

• 712 m rotary-percussive drilling for the installation of piezometers

The project took 22 months to complete, working on day and night shifts. Since its launch the hydroelectric plant has become an essential generation contributor to Central Interconnection System (system that spreads from Taltal to Chiloe and concentrates 92% of the population), covering about 3.3% of this system’s demand.
